How do you define PCN notification lead time in LCD display module contracts?

Custom Special-Shaped LCD Modules with LVDS / eDP / MIPI Integration

For OEM devices where non-standard display shape, active area, FPC direction, interface path, and equipment-level fit need to be reviewed before sample planning.

For any OEM or system integrator, an unexpected change in a critical component like an LCD display module can disrupt production and create field reliability risks. A Product Change Notification (PCN) is supposed to prevent this, but its value depends entirely on timing—and on whether the contract language makes timing enforceable.

PCN notification lead time is the contractually agreed minimum advance notice a supplier must provide before implementing a change that affects an LCD display module’s form, fit, function, reliability, or supply continuity. If lead time is defined correctly, customers can requalify, control traceability, and manage inventory so changes don’t create mixed builds or line-down events.

A contract document highlighting PCN lead time clauses for LCD display modules
Defining PCN Lead Time in LCD Module Contracts

In LCD Module Pro customer programs, “minor” changes can still produce major system effects because a display module is a tightly integrated assembly: glass cell, backlight, driver ICs, firmware, and mechanical/optical elements. Any change in those elements can shift optical performance, power behavior, EMI signature, or interface timing. Without adequate notice, incompatibilities are often discovered only when changed modules reach incoming inspection—or worse—when they are already on the production line.

The practical challenge is that a supplier’s internal change timeline rarely matches the customer’s requalification and inventory planning needs. A robust PCN process1 with a clearly defined lead time closes that gap and turns change from a surprise into a scheduled engineering activity. The sections below show how to define and negotiate PCN lead time so it protects lifecycle commitments and supply continuity.

What is PCN notification lead time, and why does it matter for LCD display modules?

PCN notification lead time is the mandatory window between when a customer receives a formal PCN and when the change can take effect in production shipments.

PCN lead time is the minimum advance notice required before a change affects an LCD module’s form, fit, function, reliability, compliance, or supply. It matters because display modules are sensitive systems: changes to driver ICs, backlight LEDs, optics, or firmware can break compatibility, alter performance, or increase field risk unless customers have time to validate and plan.

An engineer comparing old and new specifications for an LCD display module after a PCN
Importance of PCN Lead Time for LCD Modules

A display module’s behavior can change with component substitutions that look harmless on a BOM. A backlight change can shift color or uniformity. A driver IC change can alter power-on timing and expose bring-up sensitivity. A firmware revision can change brightness mapping or gamma behavior. The point of lead time is to give customers room to obtain samples, validate in the real end product, and either approve the change or execute a controlled transition.

Why Every Detail Matters in an LCD Module

Because the display is deeply integrated, customers need time to evaluate real impacts rather than assumptions. Validation is usually not “plug it in and look.” It often includes power sequencing checks, thermal soak, repeated power cycling, EMI/EMC screening (where applicable), and regression testing of brightness, color, and touch/cover-lens interactions if present. Lead time is what makes those activities possible before changed units arrive in volume.

Turning Surprises into Scheduled Events

The operational value of lead time2 is control. It lets engineering, quality, and supply chain teams run a defined workflow: review → sample → verify → document → approve (or reject/transition). For long-lifecycle industrial and kiosk products, that workflow is the difference between a controlled change and an unplanned production stop.

Which changes should trigger a PCN, and how does that affect lead time tiers?

Not all changes carry the same risk, so a tiered PCN framework is usually more practical than one universal lead time.

A PCN should trigger for any change that could affect form, fit, function, reliability, compliance, traceability, or manufacturing site/process. Contracts work best when they classify changes into tiers (major/minor/notification-only) and assign different lead times and deliverables to each tier so high-impact changes receive the most runway.

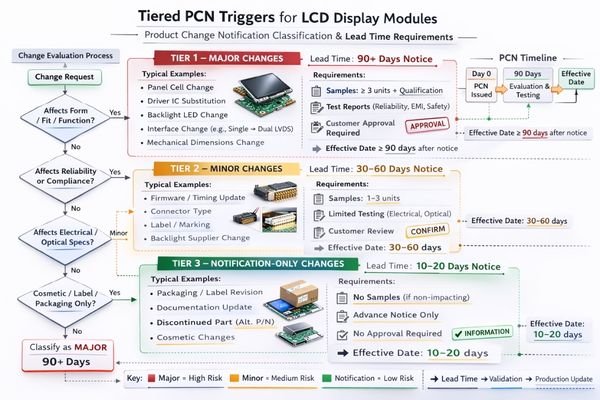

A flowchart showing tiered PCN change levels for component management
Tiered PCN Triggers for LCD Display Modules

The objective is to avoid “notification fatigue” while protecting against changes that can break integration or field performance. A typical tiering approach3 is:

  • Major Changes: High likelihood of affecting integration/performance and often require customer validation. Examples include panel cell or TCON changes, driver IC substitutions, backlight LEDs or optical stack changes (LGP/diffusers), FPC/connector design changes, firmware revisions that affect timing or brightness mapping, and manufacturing site/process changes that can shift reliability.
  • Minor Changes: Lower impact, but still require notice and clear identification. Examples include passive substitutions with equivalent specs, minor mechanical material revisions that do not affect fit, or packaging changes that affect handling.
  • Notification-Only Changes: Administrative updates (labels, documentation, carton artwork) intended for traceability rather than engineering action.

The key is to define tier boundaries clearly so a high-impact change cannot be reclassified as “minor” to shorten notice.

How do you choose a practical lead time that supports requalification and inventory planning?

A practical PCN lead time is determined by the customer’s requalification and supply chain cycle time, not by the supplier’s internal schedule.

Choose lead time by working backward from your required actions: review, sample, validate, document, and approve—plus procurement and logistics time to build buffer stock or execute a last-time buy. Lead time should be long enough to complete requalification before the effective date or to bridge production with controlled inventory.

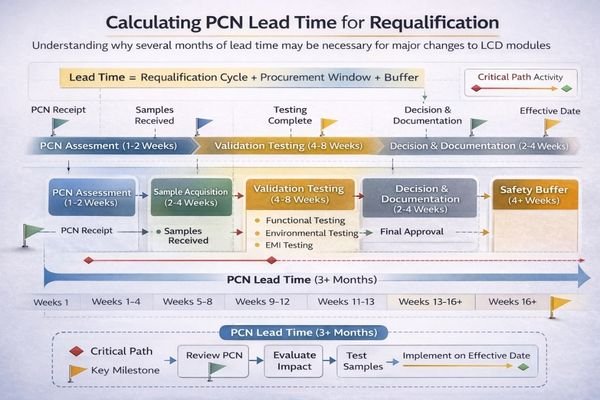

A project timeline illustrating the stages of component requalification
Calculating PCN Lead Time for Requalification

A defensible approach is to map the full post-PCN workflow and then add a buffer for iteration. Reliability and environmental tests often dominate the schedule, and display issues can be delayed (thermal soak, repeated power cycling, or corner-case EMI). The table below is a planning template to help teams size lead time based on their actual process.

Requalification Phase Key Activities Time Consideration
Phase 1: Assessment Engineering review of PCN, risk analysis, sample request. 1-2 weeks
Phase 2: Sampling & Build Supplier ships samples, customer receives them and builds them into test systems. 2-4 weeks (depends on sample availability and shipping)
Phase 3: Validation Functional testing, environmental screening (e.g., thermal shock, vibration), EMI/EMC checks, reliability testing (e.g., power cycling). 4-8 weeks (reliability tests can be long)
Phase 4: Decision & Logistics Final approval, documentation updates, and placing a last-time buy order if the change is rejected or requires a longer transition. 2-4 weeks
Safety Buffer Accounts for unexpected delays, test failures, or a second validation loop. 4+ weeks

Many teams use lead-time ranges based on this reality (often several months for major changes), but the most robust rule is: lead time ≥ requalification cycle4 + procurement window + buffer.

What contract language prevents loopholes in PCN lead time and effective date?

Lead time only works if the contract defines when the clock starts, what “effective date” means in practice, and how traceability is enforced.

To close loopholes, define that lead time starts on customer receipt (with receipt confirmation for major changes), define effective date as the earliest date changed units may be manufactured/ship/be used for customer orders, require traceability and lot segregation, and grant the customer the right to reject unidentified or early shipments.

An image of a magnifying glass over a contract's fine print about effective dates
Contract Language for PCN Lead Time

Precision matters most in four areas:

Defining the Start and End Points

Specify that the lead-time clock starts when the customer receives the PCN via agreed channels, not when the supplier internally “issues” it. For major changes, require acknowledgment of receipt to avoid disputes. Define effective date so it cannot be bypassed—tie it to the earliest date changed product can be manufactured, shipped, or applied to customer purchase orders. This helps prevent “quiet” mixed builds entering the supply stream before validation is complete.

Ensuring Traceability and Segregation5

Require clear identification for changed builds: new revision codes or new part numbers for major changes, shipment documentation that references the revision, and lot segregation rules (no mixed shipments unless explicitly agreed). Traceability should be sufficient for incoming control and field tracking, so customers can quarantine or roll back if issues are found.

How should you recommend PCN lead time terms to balance risk, cost, and supply continuity?

A good contract balances customer protection with real supply-chain constraints by using tiers, defined deliverables, and an emergency transition path.

The best PCN terms use tiered lead times tied to change severity and bind each tier to deliverables: for major changes, advance samples, a no-ship-before date, and customer approval expectations; for minor changes, shorter notice with clear identification; and for urgent EOL/safety events, immediate notice plus a mutually agreed transition plan.

A diagram showing the balance between risk, cost, and supply continuity in contracts
Balancing PCN Terms for LCD Modules

A practical framework is:

  • Tiered lead times tied to risk: Longer lead time for changes that can alter timing, optics, power, reliability, or compliance; shorter lead time for low-impact changes.
  • Deliverables that make PCNs actionable: change description, affected part numbers, reason, impact summary, effective date, sample availability, and required customer actions.
  • Emergency path for unavoidable events: immediate notification, interim containment (lot segregation / identification), and a coordinated transition plan that may include last-time buy options.
  • Governance: defined PCN recipients, response SLAs, escalation contacts, and periodic roadmap reviews to reduce surprise changes.

The intent is to keep necessary supplier improvements possible while ensuring customers never lose control of qualification timing and production continuity.

FAQ

What’s a reasonable PCN lead time for high-risk LCD module changes?
It should cover your full requalification cycle plus buffer. Many teams align “major change” lead time to allow sampling, validation, and a last-time buy option before any shipment of changed units.

Should firmware updates always trigger a PCN?
If firmware affects timing, brightness mapping, power behavior, or compatibility, it should trigger a PCN. Purely internal tooling changes with no functional impact may be handled as a lower tier.

How do we prevent receiving mixed old/new builds without notice?
Require revision identification, lot segregation, and “no mixed shipment” rules tied to the effective date, plus the right to reject unidentified lots.

What should a PCN include to be actionable?
Clear description, affected part numbers, effective date, reason for change, risk/impact summary, and any required customer actions plus sample availability.

Can we require longer lead times for end-of-life or last-time-buy notices?
Yes. EOL and last-time-buy timelines often need more planning because they affect inventory strategy, approvals, and service commitments.

Who should own PCN review on the customer side?
Typically a cross-functional owner set: engineering, quality, and supply chain, with defined SLAs and escalation paths.

Conclusion

In LCD display module integration, managing change is a core lifecycle requirement. Defining PCN notification lead time in supply contracts is the most effective way to turn unpredictable component changes into a controlled process. The essentials are specific definitions and closed loops: tiered triggers, lead time based on your requalification needs, receipt-based timing, clear effective-date rules, and traceability/segregation requirements that prevent silent mixed builds.

At LCD Module Pro, we treat PCN terms as part of integration stability: clear interface documentation, disciplined change control, and predictable transitions that protect production continuity and long-term field reliability.
